|
|
|
In January 2002, China National Offshore Operating Company (CNOOC),
formerly Repsol YPF, completed the first multilateral well of the
East Rama field in the Java Sea, Indonesia, using a RapidConnect system.[note 2]

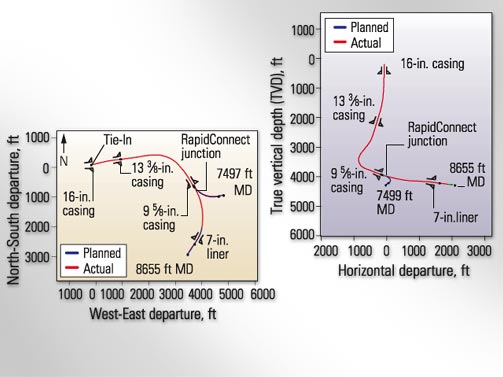

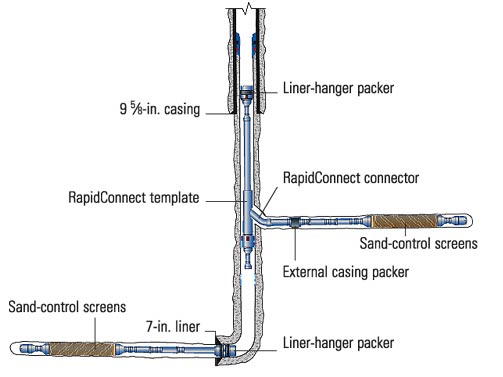

Each lateral branch of Well AC-06 targeted two pay zones. The 7-in. primary
casing
string included a primary and a backup ICC.
The lower 6-in. lateral was drilled and completed with a liner with a 4-in. Weatherford
expandable sand screen (ESS) and expandable isolation sleeve (EIS) assembly and
41⁄2-in. blank pipe below a 7-in. liner packer. |
The upper 6-in. lateral was drilled and completed with a 4-in. ESS and EIS assembly,
4 1⁄2-in. blank pipe and 4 1⁄2-in. TAM International external casing
packer (ECP). A RapidConnect system installed on a tieback liner
connected the upper lateral
completion assembly with the main wellbore.
An electrical submersible pump set in the 9 5⁄8-in. casing finalized
the completion. Production from the laterals was commingled at a stabilized
oil rate of 874 m/d [5500 B/D] and 128,864 m/d [4.5 MMcf/D] of gas |
|
Well AC-06 produces three to four times more oil than the best conventional wells
in this field and also had the highest productivity—32 B/D/psi [0.74
m/d/kPa].The AC-02 and AC-03 single-bore wells produced at 7 and
12 B/D/psi [0.16 and 0.28 md/kPa], respectively.
The AC-06 well was completed in a record 36 days—demonstrating that multilateral
technology is cost-effective for developing satellite fields and bypassed reserves.
|
|
